VANCOUVER, B.C.
Overview
A development firm is thinking of acquiring land in Vancouver and building a mixed-use building featuring retail on the ground floor and multifamily units above. The development aims to capitalize on the area's strong consumer demand, affluent demographics, and long-term growth potential.
Problem
The development firm faces financial uncertainty for their 6-storey mixed-use project due to escalating construction costs, fluctuating market conditions, lender hesitation, and growing concerns from investors about profitability. These challenges are creating significant risks to the project's financial feasibility.

Solution
Pinnacle Real Estate provides expert underwriting services, including creating dynamic financial models, optimizing the capital stack, and preparing lender-ready documentation. Pinnacle Real Estate also stress tests different construction budget assumptions and offers creative ways on how to maximize returns. These solutions address financial risks, secure funding, and restore investor confidence, ensuring the project's success.

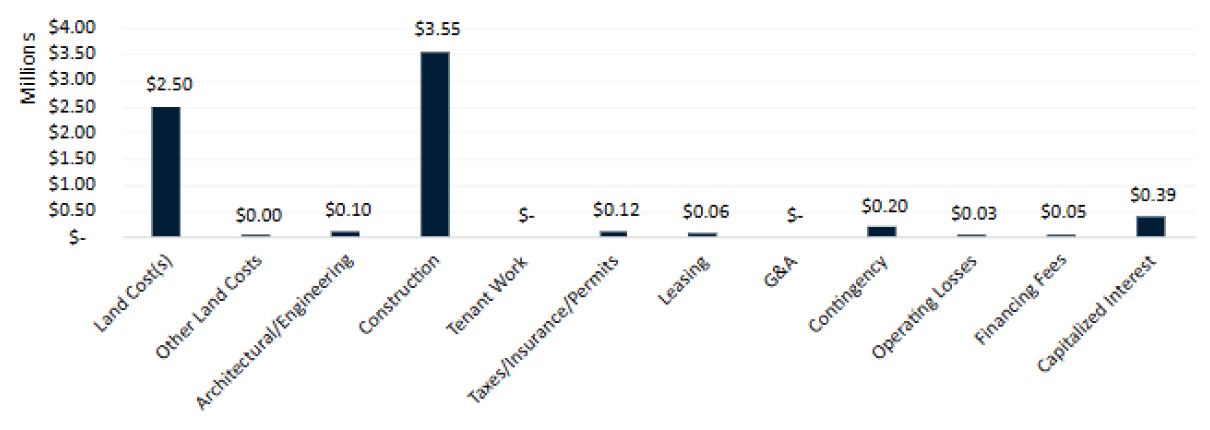

Development Budget Chart
This chart provides a clear breakdown of cost allocations, helps manage cash flow, supports communication with lenders and investors, and identifies financial risks. It is also used as tool to understand which costs would require the most amount of money and seek some potential opportunity in lowering those costs.

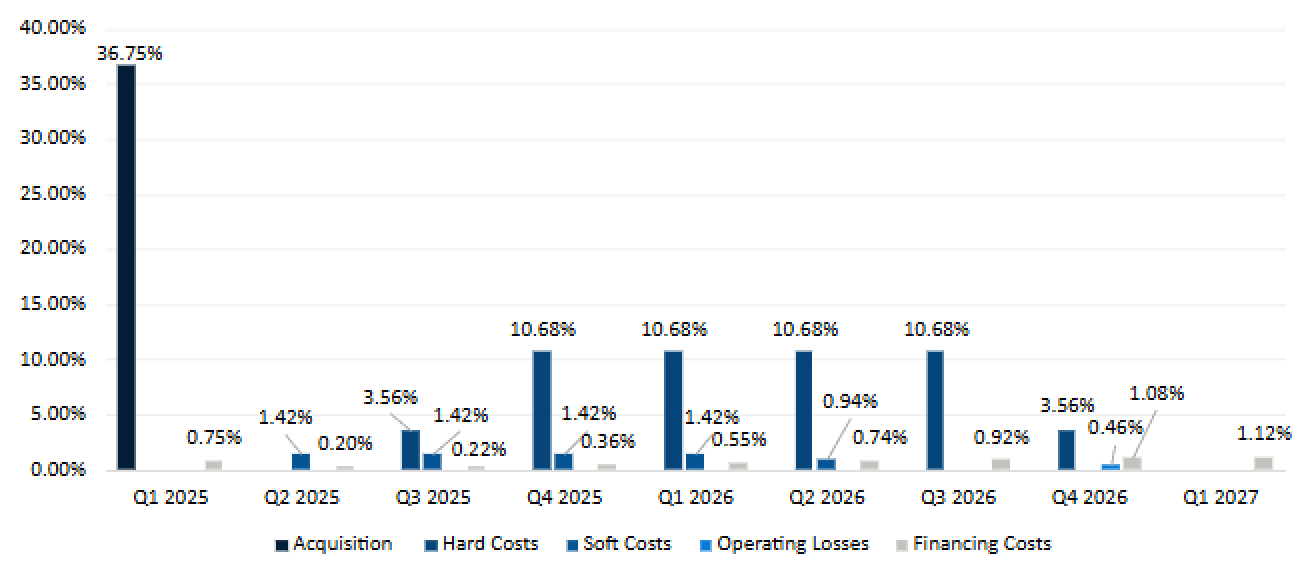

Project Cost Distribution
Understanding when cash is deployed into this project helps development firms prioritize resources, manage cash flow effectively, and identify potential risks early. It also enables better financial planning, ensures alignment with project goals, and improves communication with stakeholders like lenders and investors.

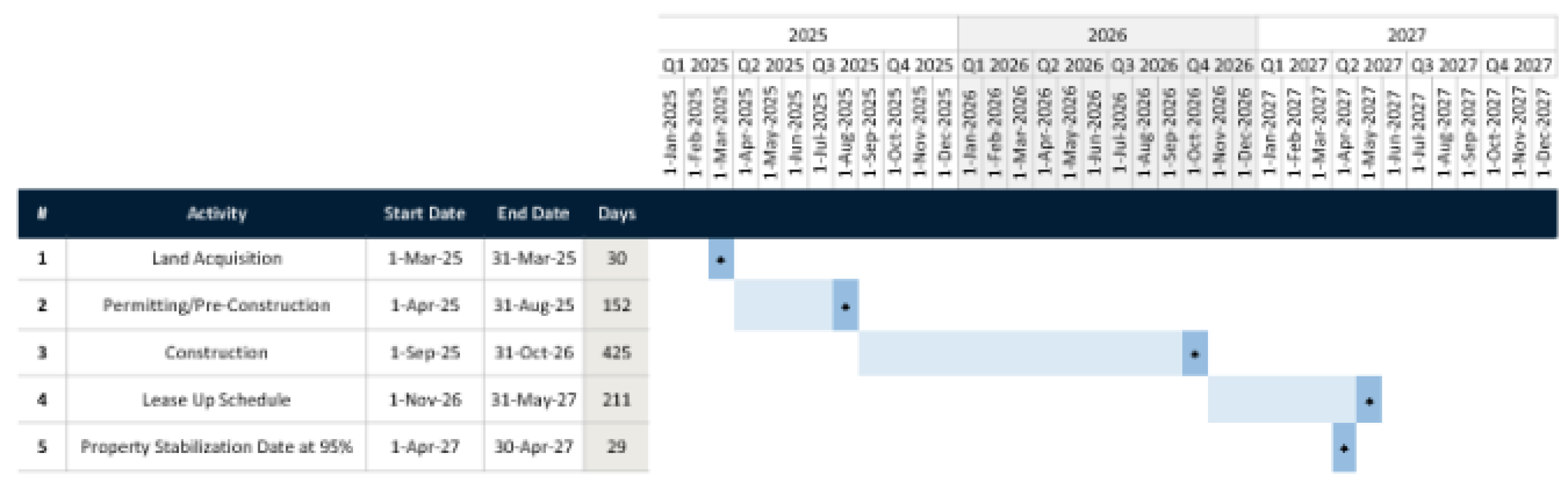

Project Timeline
This Gantt Chart allows development companies to track different project phases, dependencies, and deadlines. It helps coordinate teams, identify critical paths, and manage risks, ensuring smooth execution from planning to construction and leasing.

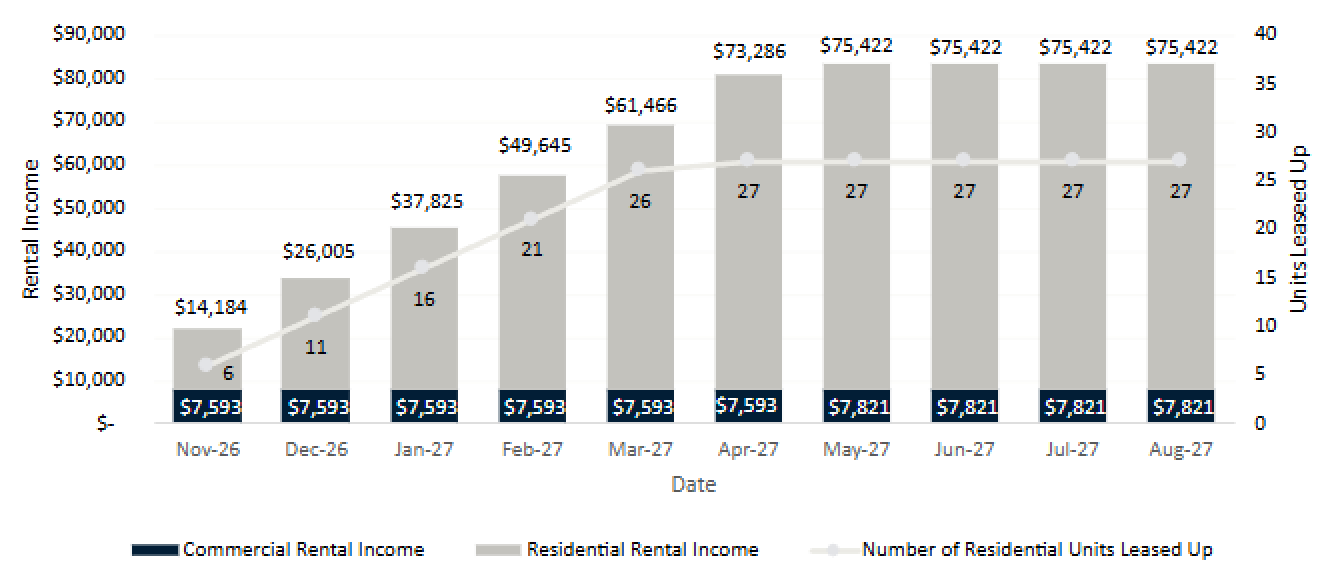

Lease Up Schedule & Rental Income
Including this chart is crucial for showcasing rental income growth and leasing performance over time. It highlights the balance between commercial and residential revenue, tracks leasing progress, and identifies stabilization milestones. This clear visualization supports investor decision-making by demonstrating the project's financial viability and operational success.

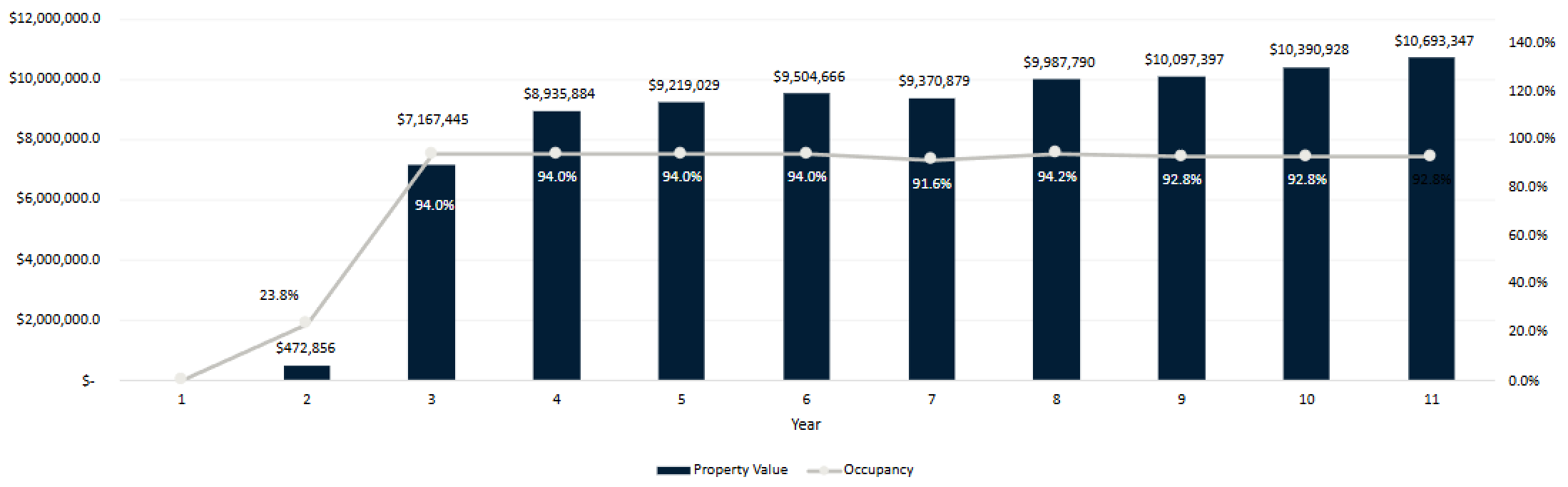

Retail + Multifamily Development Valuation
A Property Valuation vs. Occupancy % chart is invaluable for real estate developers and investment firms as it illustrates the timeline for tenant occupancy and identifies the optimal year to sell the property for maximum returns. This visualization provides critical insights into both revenue generation potential and strategic exit timing. A sensitivity analysis table allows potential investors to evaluate various exit cap rate scenarios and identify the one that aligns best with their desired returns.

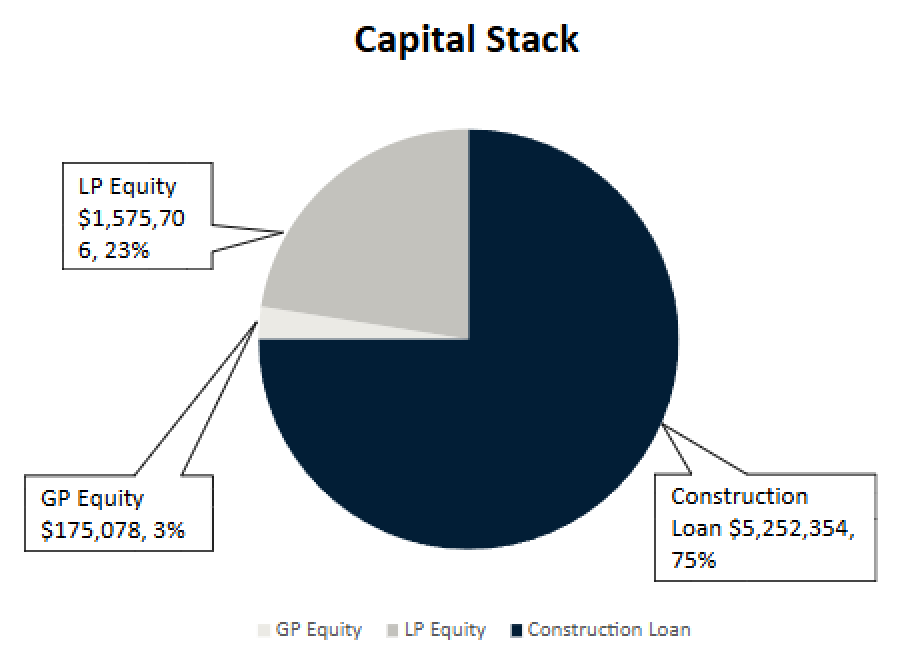

Retail + Multifamily Development Capital Stack & Promote Structure

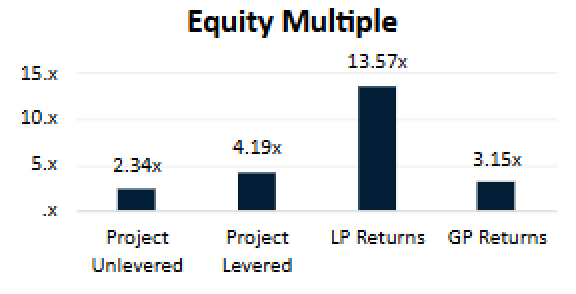

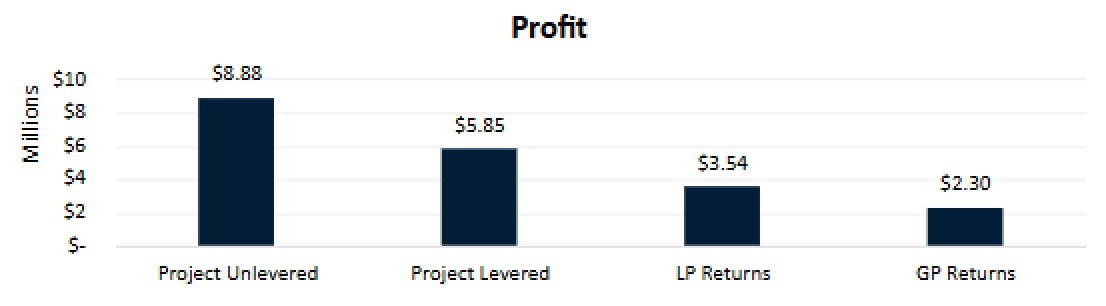

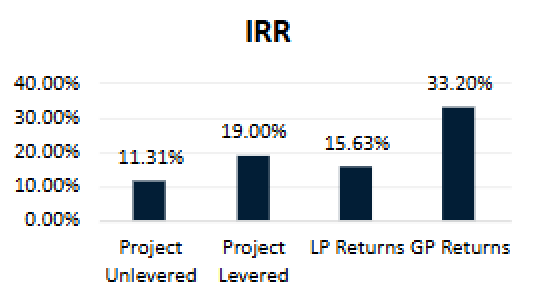

This set of visuals highlights the capital structure, financial performance metrics, and return potential. The charts provide a clear breakdown of returns, including IRR, equity multiples, and profit distributions, while demonstrating the impact of leverage on investment outcomes. These visuals are essential for conveying the deal's structure, performance potential, and investor benefits with transparency and clarity.
